Industrial Dehumidification

The Commercial Dehumidifier Guide: Selection in 9 Steps

How to select a commercial dehumidifier in 9 steps: define the target, calculate the moisture load (worked example), set the design condition, refrigerant vs desiccant, format, unit count, installation, controls and acceptance.

Written byYakeclimate Engineering TeamEngineering TeamReviewed by Jordan Shao, R&D Director
Four commercial humidity-control objectives: air RH, condensation, material drying, and quality conditions over time.

Quick answer: Select a commercial dehumidifier in nine steps. (1) Define what you control: RH, dew point, material moisture or a quality outcome. (2) Calculate the moisture load from ventilation, infiltration, people, processes and products. (3) Set the design operating condition, meaning the air temperature and RH entering the unit at the demanding period. (4) Choose refrigerant or desiccant. (5) Choose the format: portable, floor, ceiling or ducted. (6) Set the unit count from capacity and air distribution. (7) Plan installation: power, drainage, ducts, access. (8) Plan controls and monitoring. (9) Agree acceptance tests. Ask suppliers for capacity at your condition, not just the catalogue rating.

Quick answer
  • Target → load → design condition → technology → format → count → installation → controls → acceptance.
  • Capacity at your inlet condition decides the selection.
  • Floor area alone never sizes a commercial unit.

Step 1: define what you control

ObjectiveUse whenExample
RH at a stated temperatureMaterials, comfort, storageWarehouse at 50 % RH, 20 °C
Dew pointCondensation on cold surfacesElectrical cabinet, cold store dock
Material moistureDryingWater-damaged structure, slab
Biological or quality outcomeMould, disease, shelf lifeGreenhouse crops, food storage

A space can hold 50 % RH and still condense on a chilled surface. Choose the variable that matches the risk; see dehumidifier settings for mould prevention.

Step 2: calculate the moisture load

Worked example (illustrative): a warehouse brings in 2,000 m³/h of outdoor air at 25 °C / 70 % RH (13.9 g/kg); target 20 °C / 60 % RH (8.7 g/kg).

  • Excess water per kg of air: 5.2 g.
  • Air mass: about 2,400 kg/h → about 12.4 kg/h ≈ 300 kg/day, before internal sources.

Size for the demanding period, not the average, and check pull-down separately. See commercial dehumidifier sizing.

Step 3: set the design operating condition

Capacity depends on inlet temperature and RH. Ratings are at test conditions (for example 30 °C / 80 % RH or 27 °C / 60 % RH, depending on market) that are often warmer and wetter than your space. Request capacity at your condition; see what a daily removal rating means.

Step 4: refrigerant or desiccant

ConditionUsual route
Warm, moderate RH targetRefrigerant
Cold space, or dew point below about 5 °CDesiccant
Warm, high load, very low dew pointRefrigerant + desiccant

See refrigerant vs desiccant.

Step 5: choose the format

FormatSuits
PortableTemporary, restoration, small spaces
Floor-standing industrialWarehouses, workshops
Ceiling-mountedFloor space limited; greenhouses, food plants
DuctedEven distribution; plant rooms; pools

See commercial portable dehumidifiers and ceiling dehumidifiers.

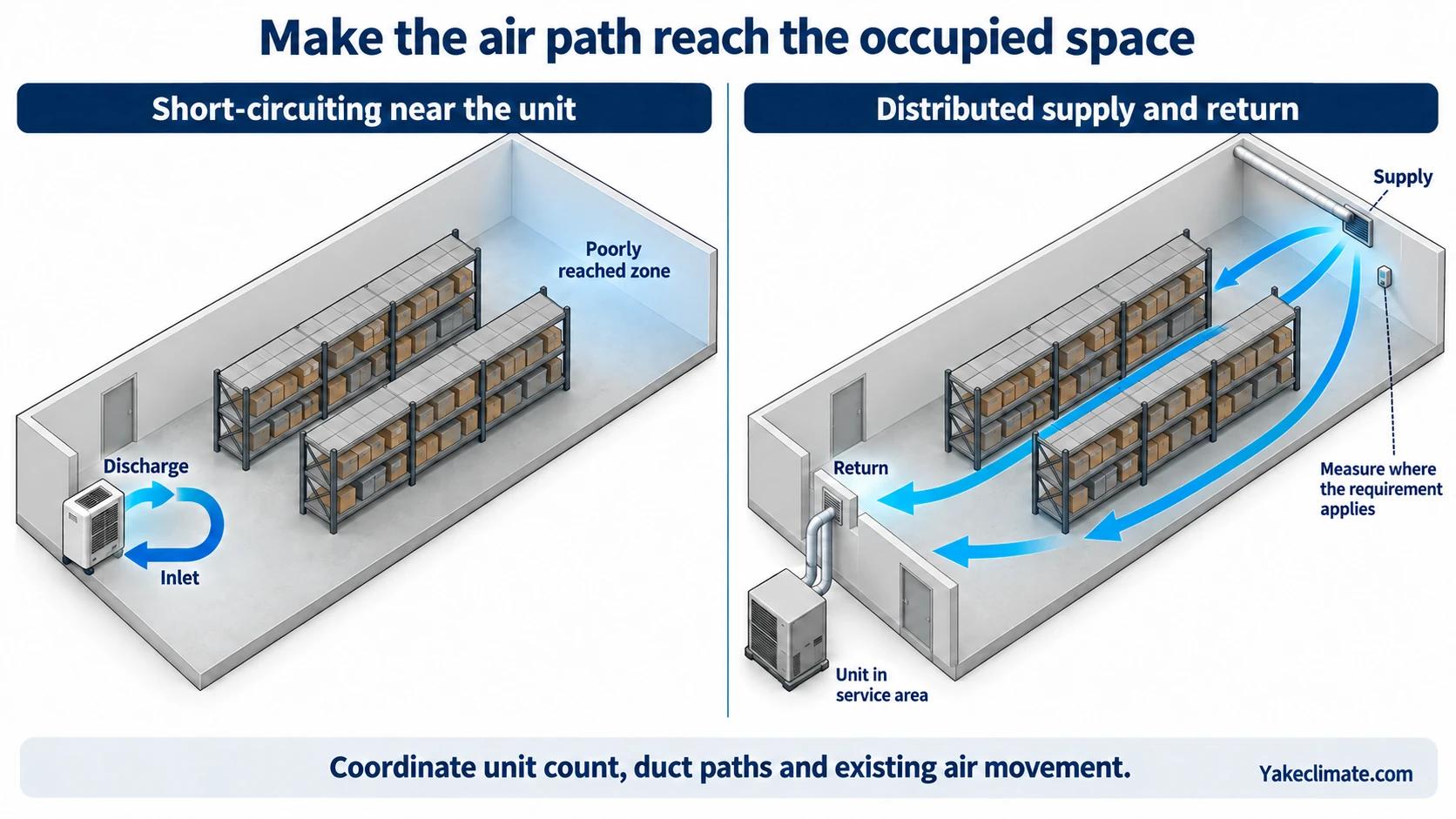

Step 6: unit count from capacity and distribution

N = load ÷ capacity at the design condition, rounded up, then checked for coverage and redundancy. See large commercial dehumidifiers.

Step 7: installation

Power (voltage, phases, kW), drainage (gravity or pump; see condensate pump planning), ducts, mounting, service clearances.

Step 8: controls and monitoring

Sensor location, setpoint and deadband, staging, BMS interface, alarms (high humidity, drain, faults).

Step 9: acceptance and verification

Agree the target, measurement points, period and tolerance; trend for several days in the demanding season; record a baseline for maintenance (see the maintenance checklist).

Information to prepare

Space and use, target, moisture sources, ventilation, temperature range, preferred format, power, drainage, controls, schedule. Send to us via our industrial dehumidifiers page.

FAQ

Frequently asked questions

How do I choose a commercial dehumidifier?

Define the target, calculate the load, set the design condition, choose technology and format, then size the count at that condition.

What size commercial dehumidifier do I need?

Enough capacity at your operating condition to remove the moisture load in the demanding period.

Why does my dehumidifier underperform its rating?

Ratings are at warm, humid test conditions; at cooler or drier inlet conditions, capacity is lower.
