A large commercial dehumidifier is not simply the largest model in a catalog. In a real project, large means the moisture load, airflow route, power supply, drainage volume, transport path and service access all become design constraints.
Use this guide with the industrial dehumidifier product family, the industrial dehumidification resource page and the broader commercial dehumidifier selection guide before comparing model numbers.
Define What Large Means for the Project
Large may mean high water removal, high airflow, long throw distance, ducted distribution, three-phase power, heavy equipment weight or continuous duty. The buyer should define which constraint is actually large before requesting a model.
The industrial dehumidifier specifications checklist is the right starting point because it separates the target condition, moisture source, airflow and installation boundary.
Start With Moisture Load, Not Floor Area
Floor area describes the space, but it does not describe the amount of water entering the air. Moisture can come from infiltration, wet goods, product drying, washdown, doors, people, process tanks or crop transpiration.
A good large-unit selection states the normal load, peak load and recovery requirement separately. This avoids choosing a catalog capacity that looks high but is rated at a different inlet condition.
| Load input | Question to answer |
|---|---|
| Moisture source | Where does the water enter the air? |
| Operating period | When does peak risk occur? |
| Target condition | Is the goal RH, dew point or process moisture? |
| Infiltration | How much outdoor air enters the space? |
| Recovery time | How quickly must the site return to target? |
Split the Scenario Before Freezing Capacity
For a hypothetical tomato greenhouse or other long-zone project, scenario sizing should separate crop moisture, infiltration, peak duration and redundancy before anyone concludes whether one large unit or distributed units are suitable. This is a planning illustration only: it contains no Yake project record, equipment count, measured result or cost conclusion.
| Scenario question | Lower-load interpretation | Higher-load interpretation | Selection effect |
|---|---|---|---|
| Crop moisture source | Measured water balance or crop model supports a lower night load. | Mature canopy and conservative latent-load assumption are used. | Capacity can move by a large margin before any model is chosen. |
| Infiltration | Tight structure and short door events. | Aging seals, leakage and outdoor-air moisture are included. | The same floor area may need a much larger installed capacity. |
| Peak duration | High RH lasts only a few hours after the vents close. | High RH persists through most of the night. | Average-load sizing with buffer may be acceptable, or peak sizing may be required. |
| Redundancy | No maintenance reserve specified. | N+1 or staged reserve required. | The quoted quantity and control logic both change. |
This is why the RFQ should ask for scenario assumptions, not only a large-capacity model. A supplier cannot responsibly optimize capacity, quantity and layout when the design basis is still a single blended number.
Map Airflow Before Accepting Capacity
A high-capacity machine cannot control humidity in a dead zone if dry air never reaches it. Warehouses, long aisles, crop rows, mezzanines and divided rooms often need distribution review before equipment selection.
Ducted supply, return location, circulation fans or several smaller units may solve the air path better than one central machine. The answer depends on the room shape and where moisture is released.
| Check | One large unit remains plausible when | Distributed units gain weight when |
|---|---|---|
| Air reach and zoning | One verified supply and return path reaches every controlled zone with compatible setpoints. | Partitions, long travel distances or different setpoints and schedules create separate zones. |
| Load and staging | Design and recovery duty are met with acceptable turndown and control behavior. | Loads vary by zone or staged capacity avoids cycling and part-load mismatch. |
| Continuity | Planned shutdown or maintenance downtime is acceptable. | Humidity control must continue during one unit's maintenance or fault. |
| Utilities and access | Central power, drainage, transport and service clearance are available. | Site limits favor smaller electrical feeds, shorter drains or separate service routes. |
| Validation | Confirm load, distribution, control range and outage consequence. | Confirm combined and staged capacity, sensor ownership and failure sequence. |
Use these conditions to choose an architecture for detailed design, not to infer an equipment count. Final quantity still requires the project load, rated operating conditions and verified air-distribution layout; the hypothetical tomato scenario cannot establish it.
Check Power, Access, Drainage and Maintenance

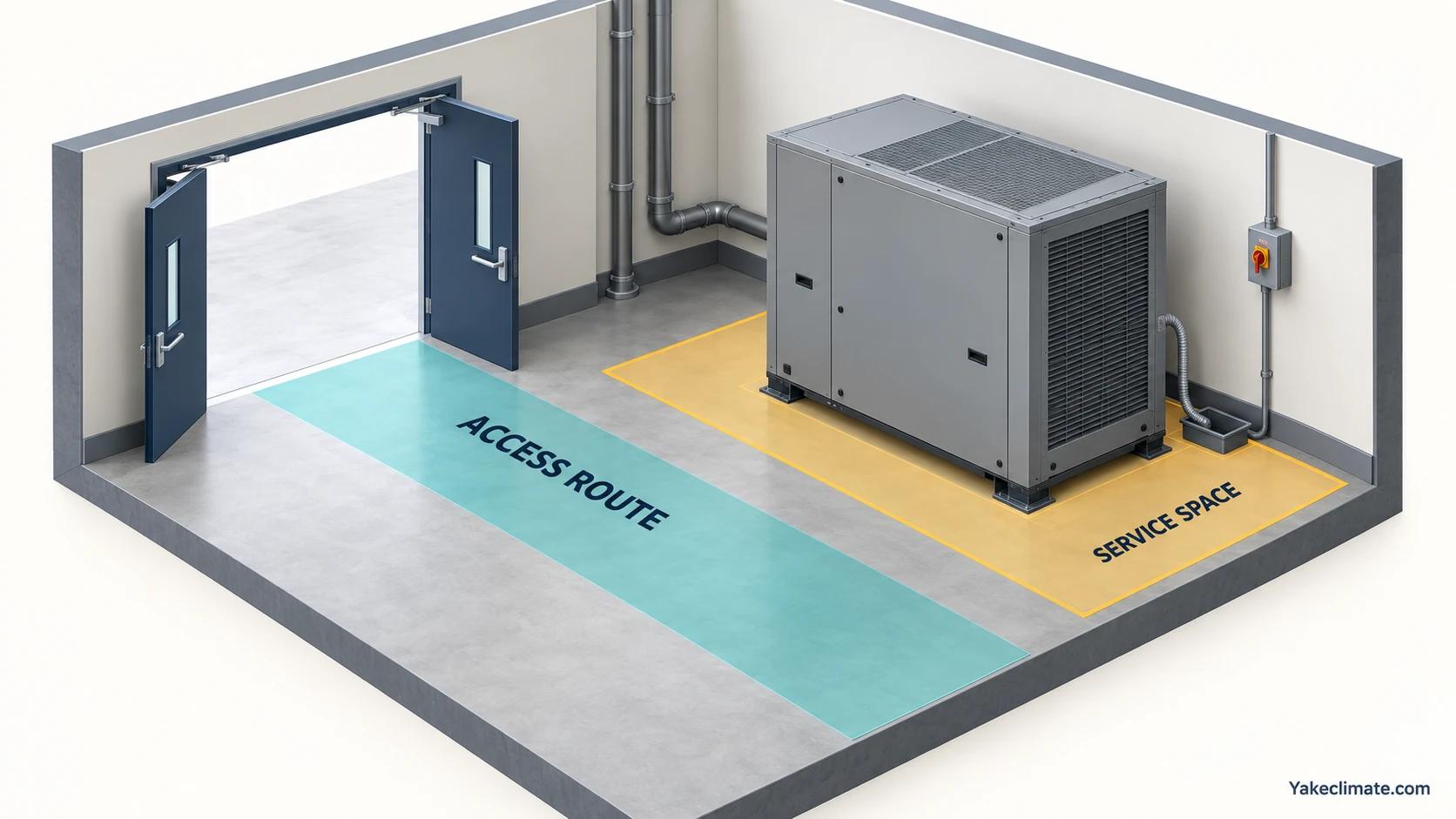

Large units create site work. Electrical supply, breaker capacity, equipment weight, doorway clearance, forklift route, condensate drainage, noise and service clearance can all decide whether a unit fits.
Use the industrial dehumidifier installation site readiness checklist before the model is frozen. If the unit produces condensate on site, include commercial dehumidifier drainage planning before the quote is treated as complete. Running cost should be estimated with the industrial dehumidifier running cost calculation framework after load and operating hours are known.
Use Stated Conditions for Capacity and Airflow Claims
Moist-air properties and air-conditioning processes should be explained through psychrometrics, such as ASHRAE's psychrometrics reference.
Use This Topic as an RFQ Filter
For the input list, start with the industrial dehumidifier specifications checklist. State the operating condition, moisture source, airflow path, site limits and open assumptions before comparing a model number.
Keep the one-large-versus-distributed decision tied to the design condition, air reach, staging, utilities, drainage, maintenance access and redundancy. Unknown values should remain visible rather than being replaced with a rough capacity estimate.
Keep later changes to temperature, load, airflow, drainage, power or controls attached to the design basis so the recommendation can be reviewed when the site changes.
Assign equipment, installation, controls, commissioning and site responsibilities before procurement; the final result depends on all of those boundaries.
FAQ
Frequently Asked Questions
Is one large commercial dehumidifier better than several smaller units?
Not always. One unit can simplify service, but several units can improve distribution, zoning and redundancy in long or divided spaces.
Can I size a large commercial dehumidifier by square footage?
No. Square footage is only a space description. Moisture load, target condition, airflow path and recovery time decide the capacity.
What data is needed before selecting a large industrial dehumidifier?
Provide temperature, humidity target, moisture source, operating hours, airflow path, power supply, drainage, installation access and control requirements.
Does higher L/day always mean better performance?
No. The stated L/day rating belongs to its named inlet-air test condition. Actual moisture-removal rate depends on operating temperature, humidity, airflow and installation conditions; operating hours then determine the total water removed over the period. Compare both the rated condition and expected runtime with the project duty.
Project Input Checklist
- Target dry-bulb temperature, RH or dew point.
- Moisture sources and peak period.
- Room shape, zoning and airflow constraints.
- Electrical supply and available breaker capacity.
- Drainage and installation route.
- Maintenance access and redundancy expectations.
Next Step
Send the moisture load, target condition, airflow drawing and site limits through the contact page. Yakeclimate can compare whether one large industrial dehumidifier, multiple units or an adapted layout fits the site.
