Three completely different products get called "moisture barriers for concrete," and choosing the wrong one is the most common reason a floor fails after installation.
They address different sources of moisture, are installed at different stages, and cannot substitute for one another. A dehumidifier will not stop ground moisture. A surface membrane will not dry a wet slab. A below-slab vapour retarder does nothing once the concrete is poured.
Establishing which problem you have comes before choosing anything.

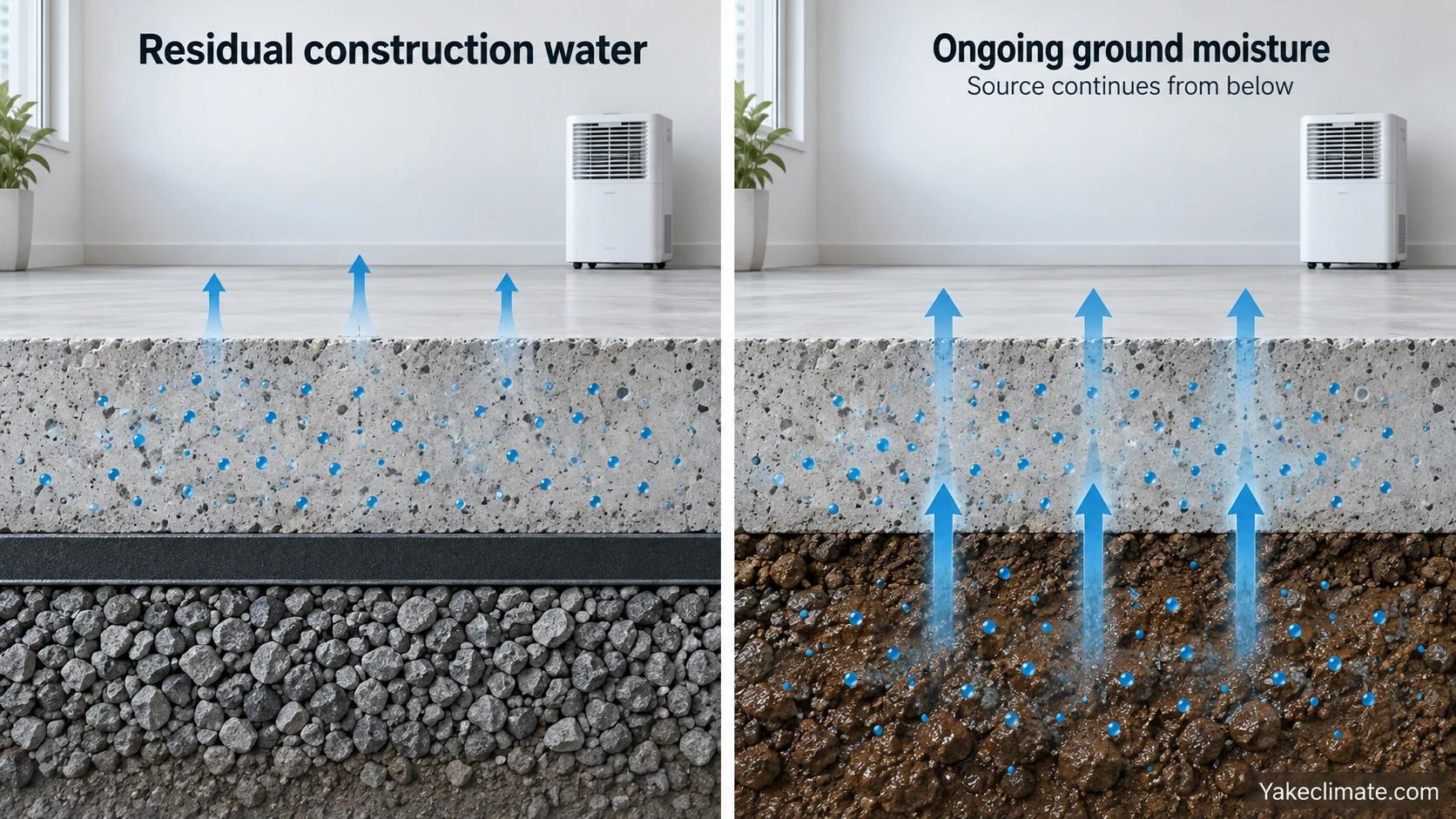

Three Functions, Not One
Below-slab vapour retarder. A sheet membrane placed under the slab before the pour, to block water vapour rising from the ground into the concrete. It addresses the ongoing, permanent moisture drive from the soil. Once concrete has been poured, this option no longer exists for that slab.
One consequence is worth knowing: a slab cast directly on a vapour retarder can only dry upward, because the retarder blocks the downward path. This makes drying slower than a slab that can dry from both faces — the retarder is doing its job correctly, and the drying schedule has to account for it.
Surface-applied moisture mitigation system. A coating or membrane applied to the top of a cured slab, forming a barrier between the concrete and the flooring above. It is used where the slab's moisture condition exceeds what the flooring can tolerate and where waiting for it to dry is not viable. These are engineered systems with specific surface preparation, application and testing requirements, and their performance depends heavily on those being followed.
Environmental drying and dehumidification. Removing moisture from the air above the slab so the slab can release its own moisture faster. This addresses residual construction water — the mix water that was not consumed by hydration.
The critical distinction, stated plainly:
Dehumidification accelerates the release of water already in the slab. It does not stop water entering the slab from the ground. If the moisture source is ongoing ground moisture, no amount of dehumidification will resolve it — the slab will keep supplying moisture indefinitely.
Getting this wrong produces the classic failure: months of drying equipment on a slab that was never going to dry, because it sits on wet ground with no vapour retarder beneath it.
Identify the Source First
| Source | Character | What addresses it |
|---|---|---|
| Residual mix water from construction | Finite; declines over time | Time, environmental drying, or a surface mitigation system |
| Ground moisture / vapour drive | Ongoing; does not decline | Below-slab vapour retarder (before pour) or surface mitigation system |
| Hydrostatic pressure | Ongoing; may be seasonal | Drainage and waterproofing engineering — outside the scope of either |
| Water event or leak | Finite, once repaired | Repair, then drying — see desiccant dehumidifiers in water-damage restoration |
| Condensation on the slab surface | Recurring, seasonal | Lowering the room's dew point below slab temperature — see warehouse humidity control |
The diagnostic that most often distinguishes them: does the moisture reading decline over time under drying conditions? Residual construction water falls, slowly but steadily. Ground moisture does not — it reaches a level and stays there, regardless of what equipment is running.
Test Before You Select
Two standard test methods are in common use, and they measure different things.
ASTM F2170 — in-situ relative humidity probes. Holes are drilled into the slab, sleeved, sealed and allowed to equilibrate for at least 24 hours before a calibrated probe is read. Drilling depth is specified as a proportion of slab thickness — 40 % for slabs drying from one side, 20 % for slabs drying from two sides.
This depth requirement is the point of the method. It measures the relative humidity the slab will equilibrate to internally once a flooring covering is in place and surface evaporation stops — which is what determines whether the flooring will be exposed to moisture after installation. Surface measurements cannot predict this, because a surface can be dry while the slab's interior is not.
ASTM F1869 — anhydrous calcium chloride. A dish of calcium chloride is sealed over a prepared area of slab, and the weight gained over a 60–72 hour period gives a moisture vapour emission rate in pounds per 1,000 square feet per 24 hours.
Its limitation is fundamental: it reflects only the surface condition, to a shallow depth. A slab whose surface has dried while its interior remains wet will produce a favourable result and then release moisture into the flooring afterwards.
They are not interchangeable. Where a flooring manufacturer specifies a method and a limit, that method must be used — a passing result by the other method does not satisfy the requirement.
Test conditions matter. Both methods require the slab and the space to be at service conditions for a defined period beforehand, because both temperature and the surrounding air condition affect the result. Testing a slab in an unconditioned building and applying the result to a conditioned one is not valid.
Why "How Long Until It's Dry?" Has No Answer
A slab passes through the same three drying phases as any wet material, described in evaporation, drying rate and dehumidification load.
Early on, the surface stays wet and drying is fast and controlled by air conditions. Then the evaporation front retreats into the slab, and the rate becomes controlled by how quickly water can diffuse through a dense, low-permeability material. Concrete is very good at holding onto water, so this second phase is long — and it is the phase that determines the schedule.
The variables that move it:
- Thickness, and whether drying is one-sided or two-sided. A slab on a vapour retarder dries only upward, roughly doubling the effective path.
- Water-cement ratio and mix design. More mix water, and less permeable concrete, both extend drying.
- Curing method and any curing compound, which may need removal before drying can proceed.
- Ambient conditions, which control the constant-rate phase and continue to set the equilibrium the slab is heading toward.
- Whether the building is enclosed and conditioned. An open building tracks outdoor conditions, which may be wetter than the target.
- Any ongoing moisture source, which as noted above changes the problem entirely.
General rules of thumb circulate widely and are unreliable, because they average across all of these. The defensible answer comes from testing the actual slab under the actual conditions and observing the trend.
Where Dehumidification Genuinely Helps
Within its limits, environmental control is effective and often the difference between meeting a programme and not.
It maintains the driving force. In an enclosed space, moisture evaporating from the slab raises the air's humidity, which reduces the gradient and slows further drying. Removing that moisture keeps the process running — without it, drying stalls regardless of how long it is left.
It lowers the equilibrium the slab is heading toward. The slab's internal relative humidity is heading toward equilibrium with the air above it. Drier air means a lower final internal RH, which is exactly what an F2170 measurement reports.
It works when the weather does not. Ventilation only dries when outdoor air is drier in absolute terms than indoor air, which in many climates and seasons it is not — the test is set out in ventilation vs. dehumidification.
Heat helps too, and is under-used. Raising the slab temperature raises the vapour pressure at its surface. The qualification is that the heat has to reach the slab, which has substantial thermal mass — heating the air alone achieves much less than it appears to.
Selection Checklist
- Identify the moisture source, using the trend under drying conditions to distinguish finite from ongoing.
- Establish the flooring manufacturer's requirement — the test method, the limit, and the conditions under which it must be met. This governs, and it varies between products.
- Test the slab by the specified method, under service conditions, at sufficient locations to represent the area.
- Compare the result against the requirement, and establish the gap.
- Assess the programme. How long until the slab would reach the limit by drying alone, at the achievable conditions?
- Choose the route. Time, environmental drying to accelerate it, a surface mitigation system, or — where the source is ongoing ground moisture — a mitigation system as the only viable option.
- Verify before installing flooring, by the specified method, and record the result.
Step 2 is the one most often skipped, and it is the one that determines everything downstream.
Common Failures
Testing by the wrong method. A calcium chloride result used where the flooring manufacturer specifies in-situ RH. The surface may pass while the interior does not.
Testing under the wrong conditions. Results obtained before the building was conditioned, then applied to the conditioned state.
Drying a slab with an ongoing source. Equipment left running for months on a slab that will never dry because it is being resupplied from below.
Assuming a rule of thumb. Programming a schedule against a general drying rate rather than a measured trend.
Installing to a deadline rather than a reading. The most expensive failure, since remediation means removing the flooring.
Ignoring the surface preparation requirement of a mitigation system. These are engineered systems, and their performance depends on preparation, application and testing being carried out as specified.
Information to Prepare
- Slab construction: thickness, age, mix design if known, and whether a below-slab vapour retarder is present.
- Whether the slab is drying from one side or two.
- Building status: enclosed, conditioned, and current internal conditions.
- Flooring to be installed, and the manufacturer's moisture requirement including the specified test method.
- Test results to date: method, depth, locations, conditions at the time, and dates.
- The trend, if more than one round of testing has been done.
- Site conditions: ground water, drainage, and any known moisture ingress.
- Programme: the date the floor must be ready.
- Available power supply and access for equipment.
- Whether the space can be enclosed and conditioned for drying.
The single most valuable item is a series of readings over time rather than a single result, because the trend distinguishes a slab that is drying from one that is not.
Discussing a Project
Yakeclimate designs and manufactures industrial dehumidification equipment for complex climate applications, with a focus on agriculture and energy projects.
We co-develop application-specific dehumidification equipment around the operating conditions, interfaces, and integration requirements of the wider project or system.
Concrete moisture testing, flooring specification, vapour retarder design and surface mitigation systems remain with the project's flooring specialists, the material manufacturers and the design team. Our scope is the dehumidification equipment used to condition the space during drying.
Review desiccant rotor dehumidifiers, explore industrial dehumidifiers, or contact Yakeclimate to review the operating conditions for your project.
FAQ
Frequently Asked Questions
Can a dehumidifier fix a slab with ground moisture underneath?
No. Dehumidification accelerates the release of moisture already in the slab, but it does not stop moisture entering from the ground. If the source is ongoing ground moisture, the slab will keep supplying it indefinitely and no amount of equipment will bring it to a stable low reading. The diagnostic is whether the reading declines over time under drying conditions: residual construction water falls steadily, ground moisture reaches a level and stays there. Ongoing ground moisture requires a below-slab vapour retarder, which is only possible before the pour, or a surface-applied mitigation system.
What is the difference between ASTM F2170 and ASTM F1869?
F2170 uses in-situ probes drilled into the slab — to 40 % of thickness for one-sided drying, 20 % for two-sided — sleeved, sealed and allowed to equilibrate at least 24 hours before reading. It measures the relative humidity the slab will equilibrate to internally once covered, which is what determines the flooring's exposure. F1869 seals a dish of anhydrous calcium chloride over the surface for 60–72 hours and reports a vapour emission rate, reflecting only the surface condition. A slab dry at the surface and wet inside will pass F1869 and fail F2170. They are not interchangeable, and where a flooring manufacturer specifies a method, that method must be used.
How long does a concrete slab take to dry?
There is no general answer, and rules of thumb are unreliable. Most of the time is spent in the falling-rate phase, where the rate is controlled by water diffusing through dense, low-permeability concrete rather than by the air. It depends on thickness, whether drying is one-sided or two-sided, water-cement ratio and mix design, curing method, ambient conditions, whether the building is enclosed and conditioned, and whether any ongoing source is present. A slab cast on a vapour retarder dries only upward, which roughly doubles the effective path. The defensible answer comes from testing the actual slab and observing the trend.
Does drying faster damage the concrete?
Hydration and drying are different processes, and concrete needs adequate curing before aggressive drying begins. Drying conditions applied too early can affect the surface. The curing requirement comes from the concrete specification and the design team, and drying should follow it rather than override it. Once curing is complete, controlled environmental drying is a normal construction activity.
Should I use a surface mitigation system or wait for the slab to dry?
It depends on the source and the programme. Where the moisture is residual construction water and the schedule allows, drying is usually the simpler route and environmental control can accelerate it substantially. Where the source is ongoing ground moisture, or where the programme cannot accommodate the drying time, a surface mitigation system is the viable option. These are engineered systems with specific surface preparation, application and testing requirements, and their performance depends on those being followed exactly.
Why did my floor fail when the slab passed its moisture test?
The most common reasons are testing by a method the flooring manufacturer did not specify, testing before the building was conditioned and applying that result to the conditioned state, testing at too few locations to represent the area, or an ongoing moisture source that a single test could not reveal. A series of readings over time, taken under service conditions by the specified method, is considerably more reliable than a single passing result.
